CONSTRUCTION TIMELINE (estimated)

Rainy day on a quiet street corner with wet pavement and overcast sky.

[ PHASE 1 ] Belgrade & Range Intersection

Week of April 20th

- setup traffic & erosion control

- removal of existing pavement and curb & gutter

- removal of portion of existing sidewalk and erect temp construction fence

-water system improvement

Week of April 27th

- Monday early morning temporary water shut off

- continue with water system improvements

- begin storm sewer construction

Week of May 4th

- continue with storm sewer construction

- begin street excavation

Week of May 11th

- continue with street excavation, etc.

Week of May 18th

- begin curb and gutter construction

- begin concrete pavement construction

Week of May 25th

- EXPECT a 1-DAY SPINNERS CLOSURE for demo and pouring of concrete sidewalk along the front and side of Spinners building.

- begin concrete of walks, planters and crosswalks

- continue with pavement construction

Week of June 1st

- bituminous street patching

- begin paver construction of sidewalks and crosswalks

[ PHASE 2 ] 200 Block of Belgrade

Estimated to begin the end of May.

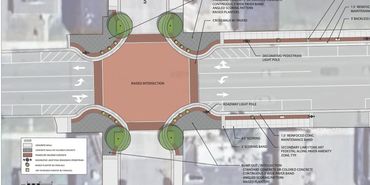

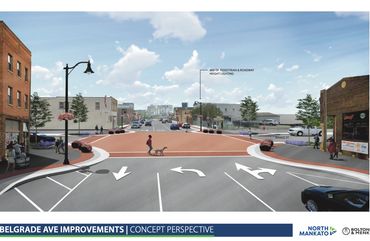

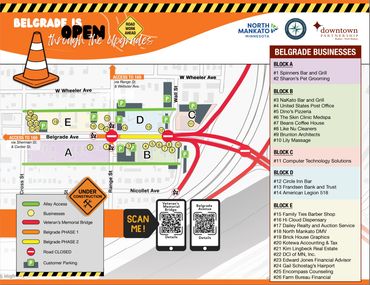

CONSTRUCTION MAPS & INFO

LINKS

Links to Additonal Information
Light Pole Art: due May 25, 2026City of North Mankato Belgrade PageMN DOT Vet's Bridge ProjectBelgrade RenderingsBusiness Access Map

Copyright © 2022 Spinners Bar and Grill - All Rights Reserved.

Powered by

  • HOME
  • MENUS
  • Construction Updates
  • GIVE US A BUZZ

This website uses cookies.

We use cookies to analyze website traffic and optimize your website experience. By accepting our use of cookies, your data will be aggregated with all other user data.

Accept
